Project-level equipment visibility provides an up-to-date record of where each piece of equipment was last confirmed, which project holds it, who is accountable for it, whether it is cleared for use, and when it is committed to return. It matters because a construction warehouse can own enough equipment and still be unable to promise it to the next project.
A project manager calls the warehouse on Friday afternoon and asks whether three generators are available for a new site on Monday. The availability record lists three, so the warehouse says yes.
On Monday, none of the three can go. The first is still at another jobsite because its crew agreed to a one-week extension by phone, and nobody changed the expected return date. The second went for repair after a crew reported a fault, but its status was never updated. The third was checked in two weeks ago, but its post-return inspection was never completed, so the record shows it as available even though nobody has cleared it for use.
No generator was lost. The record was wrong in three ways, and each error happened weeks before the phone call. Errors like these also have a slower cost: project teams that stop trusting the warehouse’s answers hold on to equipment longer, making those answers even less reliable.
Key Takeaways:
- Owning enough equipment does not mean a warehouse can promise it, because availability depends on custody, condition, and commitments.
- Equipment records drift when the people who must update them are not the people who benefit from the update.
- A reservation is a recorded claim on future equipment that lets a warehouse see conflicts before the promised date.
- Promise only equipment cleared for use, since an overdue mandatory inspection or active maintenance hold should block the promise even after check-in.
- Barcode and QR scans record the last known location, not live location, so choose tracking methods by asset class.
Measure productive utilization against eligible hours, and count planned standby equipment separately.

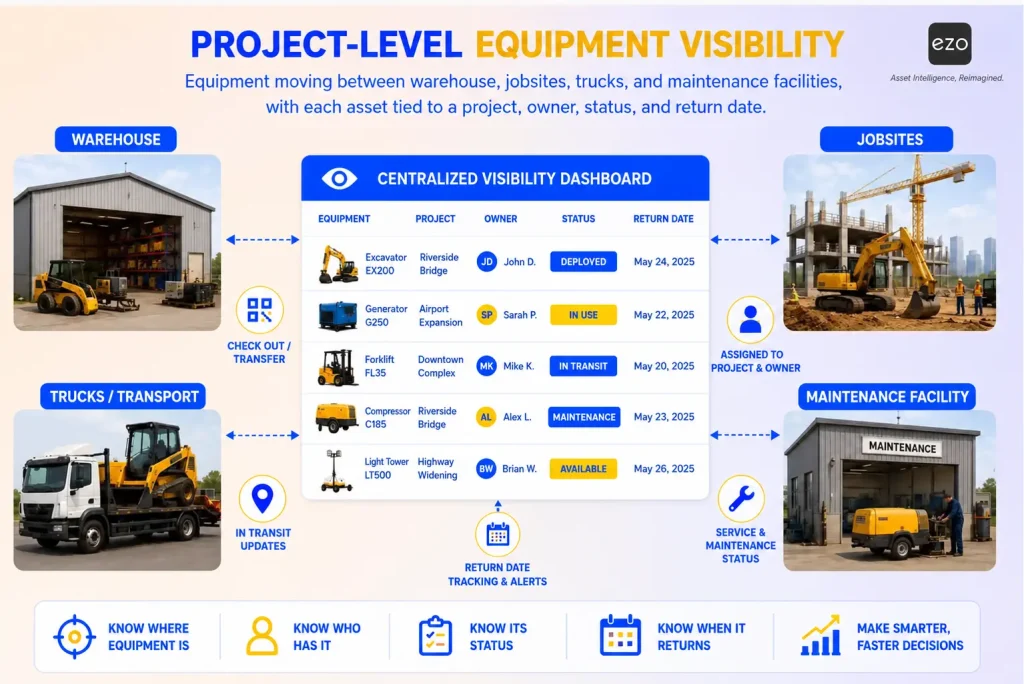

What project-level equipment visibility includes
Project-level equipment visibility combines six pieces of information about each asset: its identity, its last recorded location, the project it supports, the person accountable for it, its maintenance status, and the commitments attached to its future.
These are not stages that a warehouse graduates through. They are layers of the same record, each answering a different question.
| Record layer | Question it answers | What it cannot tell you on its own |
| Asset identity | What is this item, and do we own it? | Whether it can be used |
| Last recorded location | Where was it when someone last scanned or updated it? | Where it is now, or why it is there |
| Project assignment | Which job is it supporting? | Whether that job is still using it |
| Custodian | Who is accountable for it right now? | What condition it is in |
| Maintenance status | Is it cleared for use, overdue for a mandatory inspection, or on a maintenance hold? | When it will next be needed |
| Commitments | When is it due back, and who has reserved it next? | Whether the return date will hold |
The last column matters. Even a complete record cannot confirm that a project will return equipment on schedule or that an inspection will pass. Project-level visibility reduces the uncertainty in a warehouse’s promises. It does not remove it.
Consider a compressor recorded at “Site B.” That entry tells the warehouse where it last saw the compressor. Now consider a record that shows the same compressor assigned to Project 142, checked out to the site foreman, due back Thursday, and flagged for inspection on return. The second record lets the warehouse decide whether it can promise the compressor to another project next week, and what has to happen first.

The difference is between a record of the present and a record of commitments. Location describes where equipment is. Availability claims where equipment will be and whether it will be usable.
Why equipment records drift from reality
Equipment records drift because equipment moves in the field while someone updates its record elsewhere later, and that person gains little from the update.
Every movement between the warehouse, a jobsite, a subcontractor, a maintenance bay, and a transport team is a point where the physical asset and its record can separate. A generator can move between sites before anyone updates the tracking spreadsheet. A tool can pass from one crew to another without anyone treating the handoff as a custody transfer. The more often equipment moves, and the more sites and handoffs each move involves, the more chances the record has to fall behind.
One explanation is discipline: crews forget or don’t bother. A more useful explanation looks at who pays for an update and who benefits. The foreman who extends a generator’s stay pays to record the change when the crew is busiest. The benefit goes to the warehouse planner who will try to promise that generator next week. When cost and benefit sit with different people, records degrade even among careful crews. Training helps. The more durable fix is to make the update part of something the crew already does, such as scanning equipment out or confirming a delivery, and to name who owns each update. These informal handoffs are where technology, process, and accountability have to meet.
Records also split across spreadsheets, text messages, paper logs, and maintenance systems. Without shared workflows or integration, no single team has the complete picture. A site supervisor can extend equipment for another week without knowing that another project planned around its return. The extension may be reasonable. The failure is that nothing prompts a check. A return-date change should trigger three things: check any reservation that depends on the equipment, notify the affected project, and decide whether to reallocate or rent.
When this information depends on memory rather than maintained records, the warehouse manager becomes the default point of contact for every availability question, which fails when that person is away.
The 2018 Construction Disconnected report by FMI and PlanGrid estimated that poor project data and miscommunication caused 48% of rework in U.S. construction, more than $31.3 billion in 2018, based on that year’s construction spending. The figure covers project data overall, not equipment, so it doesn’t measure what poor equipment records cost.
Why poor visibility makes project teams hold on to equipment
When project teams cannot trust the warehouse to supply equipment on time, they keep what they already have, which makes the warehouse even less able to supply it.
Consider the foreman’s choice. Returning a pump early carries a private cost: if the job needs a pump again in two weeks, the crew may not get one. Keeping it also costs money, but someone else pays: another project rents a pump, or a warehouse can’t fill a request. Under that uncertainty, holding on makes sense for each project, even when it hurts the company.
The result is a loop. Unreliable records make availability uncertain. Uncertain availability makes holding equipment sensible. Held equipment sits idle and out of the warehouse’s reach, making availability even less reliable. Leaders then see a fleet that looks large on paper and a warehouse that cannot fill requests, and the obvious conclusion is to buy or rent more.
That conclusion is sometimes right, because some fleets are genuinely too small for their workload. But when owned equipment sits idle on one project while another project rents the same type, the first question is whether the company has a capacity problem or a trust problem. More equipment addresses the first. It does less for the second, because the new units enter the same loop.
Visibility alone does not release held equipment. A crew returns equipment early when it trusts it can get it back when needed, and a reservation provides that assurance: a recorded claim on future access the crew can see, instead of a verbal promise. None of this means equipment is lost. Lost and stolen equipment is a real cost, and the same records that reveal idle capacity also make a genuine loss visible sooner.
What poor equipment visibility costs

Poor equipment visibility rarely shows up as a single line item. It shows up as delays, rentals and purchases that owned equipment could have covered, idle equipment, overtime, and plans built on numbers nobody trusts.

A 2017 McKinsey Global Institute analysis estimated that if construction productivity caught up with the rest of the economy, the sector’s value added could rise by about $1.6 trillion. That covers construction productivity overall, not the share of equipment records.
Delays
A single generator, lift, or pump that doesn’t arrive can hold up dependent work. Not every equipment delay is a records problem: breakdowns, supply shortages, and transport failures also cause delays. In a visibility-related delay, though, the warning signs existed earlier: a missed return, an unrecorded transfer, or a maintenance hold nobody surfaced in time.
Avoidable rentals and purchases
Teams rent or buy when finding owned equipment takes too long, or when nobody trusts the record enough to plan around it. Not every extra purchase is waste. Some reflect genuine peak demand, a distant site, or a specification the fleet lacks. The cost worth isolating is the avoidable one, where suitable owned equipment was idle and reachable.
A worked example shows why the records decide the answer. The figures are illustrative assumptions, not market rates. Project B needs a light tower for three weeks. Renting one costs $600 a week, so $1,800 in total. An owned tower is idle at Project A, and moving it costs $400. Moving the owned tower appears to save $1,400.
Now add one fact: Project A needs its tower back after two weeks. Project B would use the owned tower for two weeks, rent it for the third week at $600, and pay $800 for two moves. That totals $1,400 against $1,800, a $400 saving rather than $1,400. If Project A’s return date is itself uncertain, the warehouse may also need a fallback rental, and the saving can become a loss. What decides it is whether the return date is recorded and trusted.
Idle equipment and utilization
Equipment that cannot be found, reserved, or cleared for use is unavailable, even when it physically exists. That makes it tempting to push utilization as high as possible. But standby generators, backup pumps, and safety equipment create value by being ready, so a fleet with no idle hours may simply have no reserve. If the warehouse is rewarded for high utilization, it has a reason to cut standby capacity, which looks efficient until the backup pump is needed.
A more useful definition is productive operating hours divided by the hours the equipment was eligible for use, reported by equipment class, with planned standby units counted separately. Also report the overdue return rate, the share of equipment whose location was confirmed recently, reservation conflicts, maintenance-related unavailability, and rental spending on equipment types the company already owns.
What a minimum equipment record should contain
A minimum equipment record answers eight operational questions, and each answer needs a named person who keeps it current.
| Field | Question it answers | Who keeps it current |
| Asset ID and type | What is this item? | Warehouse, at intake |
| Last recorded location and date | Where was it last confirmed, and when? | Whoever scans or moves it |
| Project or cost code | Which job is it supporting? | Project manager, at request |
| Custodian | Who is accountable for it now? | Recorded at checkout or transfer |
| Status | Is it checked out or in storage? | Warehouse |
| Expected return | When should it come back? | Project manager, with changes reviewed by the warehouse |
| Next reservation | Who needs it next? | Warehouse |
| Maintenance clearance | Is it cleared for use, overdue for a mandatory inspection, or on hold? | Maintenance lead |
The date in the second row is easy to skip, but it matters a great deal. An asset register is a claim about where things are, and the claim ages from the moment it is made. A location confirmed this morning and one last confirmed in March, deserve different levels of trust.
This record applies to individually tracked equipment with serial numbers: generators, lifts, pumps, tool kits, and safety equipment. Consumables such as fuel, fasteners, and personal protective equipment are better managed as stock quantities issued to a project than as items with their own movement history. If project schedules live in a separate project management system, the expected return date should come from that schedule rather than being typed in twice.
Financial fields come next, once the operational fields are reliable: purchase cost, depreciation, and internal chargeback rates. Linking equipment to a project and a date range is what makes an internal chargeback possible. The project that held a generator for six weeks can be charged for six weeks, instead of the cost disappearing into overhead.
A spreadsheet can hold all these fields. It struggles to keep them consistent when several people change them in different places. Equipment checkout software records changes during checkout, transfer, or return.
How to manage equipment from request to redeployment
Equipment records stay closer to reality when each step in the equipment cycle updates the record.
| Step | What happens | Who updates the record |
| 1. Request | The project submits equipment type, quantity, start date, duration, and site | Project manager |
| 2. Check | The warehouse compares the request with owned equipment that is cleared for use and not reserved for those dates | Warehouse |
| 3. Reserve | The equipment is reserved for the project and dates | Warehouse |
| 4. Dispatch | The equipment is checked out to the project and a custodian | Warehouse, by scan |
| 5. Receive | The site confirms delivery | Site foreman, by scan |
| 6. Extend or transfer | Return-date changes and moves between sites are recorded and trigger a reservation check | Project manager and warehouse |
| 7. Return | The equipment is checked in | Warehouse, by scan |
| 8. Inspect and release | Maintenance clears the equipment for use or places it on hold | Maintenance lead |
This is an operating model, not a description of what any software does automatically. Each step needs an owner.
Reservations make step 3 work, and they work only when the rules around them are clear: what happens when a return runs late, who can override a conflicting reservation, how an extension is approved, and when a late return is escalated.
Step 8 is where the third Monday generator went wrong. Keep three maintenance states separate: cleared for use, overdue for a mandatory inspection, and on an active maintenance hold. Only the first can be promised. An inspection that is coming up but not yet due leaves the equipment cleared for use, though the due date belongs in the plan.
The same records support demand planning. When projects submit requests with type, quantity, dates, and site, the warehouse can compare upcoming demand against owned, cleared, and uncommitted equipment using an availability calendar. That makes the future picture more reliable, not certain, because return dates slip and projects change.
A short example shows how the steps combine. Project A has a compressor reserved until Friday, and Project B has reserved it from Monday. On Wednesday, Project A asks for a one-week extension. Because the extension is a recorded change rather than a phone call, the warehouse sees the conflict immediately. It can confirm whether Project A’s need is real, offer Project B another cleared compressor, or arrange a rental with five days’ notice. The compressor also needs an inspection when it returns, so the warehouse schedules that inspection into the turnaround window instead of assuming it will be quick.
Good design doesn’t automatically drive adoption. Adoption improves when updates fit into steps people already perform, each step has a named owner, field users have tested the workflow on their actual devices and sites, and records are reconciled against physical counts on a schedule, for example through a periodic location audit.
Put project-level equipment visibility to the test
How to choose tracking methods by asset class
Barcodes, QR codes, RFID, and GPS answer the location question in different ways, and the right choice depends on the equipment.
| Method | How the record updates | What it tells you | Typical fit |
| QR codes and barcodes | Someone scans the label | Last scanned location, custodian, and status | Tools, attachments, smaller equipment, and warehouse checkouts |
| RFID | A reader captures tags in range, in batches, without line of sight | That the tag passed a reader point | High-volume check-ins, kits, and gates with installed readers |
| GPS and telematics | A device on the equipment reports position and, with telematics, usage | Current position and operating hours | Heavy, high-value mobile equipment |
The first two methods record events. They tell you where equipment was the last time someone scanned it, or it passed a reader, not where it is now. That is enough for a hand tool if scans happen at every handoff. It is not enough for an excavator that can move between sites without anyone touching a label. GPS and telematics close that gap for heavy equipment, but they require hardware and integration work. A fleet that includes both hand tools and heavy equipment needs more than one method, because no single method fits both.
Mobile access matters most at the handoff points: delivery, transfer, and return. Remote sites can have weak connectivity, so check whether a mobile app can record changes offline, how it reconciles them when the device reconnects, and which plan includes that capability.
Signs your construction warehouse has a visibility problem
Visibility problems tend to show up as everyday friction long before anyone names them.
| Symptom | What to check first |
| Finding equipment takes phone calls | Whether checkouts and transfers are scanned at each handoff |
| Equipment shows as available but cannot be used | Whether inspection and service states are recorded on return |
| Assets are checked out with no project attached | Whether the request step captures a project or cost code |
| Projects rent equipment the company owns | Idle owned units of the same type, and why they were not offered |
| Nobody trusts the utilization figures | How eligible hours are defined and how usage is recorded |
| Return dates slip without anyone noticing | Whether extensions are recorded and trigger a reservation check |
| Leaders hesitate to use asset data for capital decisions | When locations were last verified against physical counts |
If several of these apply, start with the handoff points, because that is where records separate from equipment.
How EZO EAM supports project-level equipment visibility
EZO EAM connects equipment records to projects, custodians, reservations, and maintenance status, and several of those capabilities depend on the plan. The plan details below come from the EZO EAM pricing page.
- Projects: Basic Project Association is available on the Premium and Custom Enterprise plans, and Advanced Projects View is available only on Custom Enterprise. The Projects module consolidates items, checkouts, reservations, and maintenance by project.
- Checkouts and custody: You can check out equipment to people or locations, so you can record a truck or jobsite container as the equipment’s location. Custody audits and transfer of custody are listed from the Advanced plan upward.
- Reservations: Reservations are listed on every plan. A company setting can prevent users from checking out or reserving items with a conflicting reservation, and admins can still override it, according to the EZO EAM help documentation. A separate setting can treat overdue items as available for future planning, meaning an overdue return must be resolved before the promised date.
- Maintenance: When a service is started, EZO EAM marks the asset unavailable until the service ends. Basic service records start on the Advanced plan. Preventive maintenance and work orders require the CMMS add-on on Premium and are included in Custom Enterprise.
- Tracking methods: Mobile apps are listed on every plan. RFID scanning is listed on Advanced, GPS integration on Premium, and telematics integration, offline mode for the mobile app, and project management tool integrations are only on Custom Enterprise. Confirm which operations the offline mode covers before relying on it at remote sites.
- Reports and alerts: Standard reports are listed on every plan, and advanced and custom reports are available on Advanced. The custodian receives an overdue email on the day an item becomes overdue.
Points to evaluate: Live location tracking depends on GPS integration (listed from Premium) or telematics integration (listed on Custom Enterprise). Project association, which this workflow depends on, starts at Premium.
Two customer stories, one from construction and one from disaster restoration, show the pattern in field work. AX Construction, a Maltese contractor, tracked equipment across 50 project sites in spreadsheets, and locating a tool could take up to five phone calls. The case study reports that it now tracks more than 2,000 tools and pieces of heavy equipment from its yard to its job sites, with audits helping site teams acknowledge possession of tools on delivery. Heroes Restoration, a disaster restoration company with four mobile crews, tracks its stocked trucks as locations and scans equipment in and out with the mobile app. Its co-owner described the stakes of a lost item: “One piece of equipment could cost $2,000.” That figure is the value of a single item, not a measured saving.
Visibility has to extend beyond the central warehouse to trucks, containers, temporary storage, and maintenance areas, wherever the equipment actually sits. More detail is on the construction equipment management page.
Conclusion
The Friday phone call was never really a question about inventory. It was a question about whether the warehouse could make a promise and keep it. That depends on records of custody, condition, and commitments, updated when equipment changes hands. It also depends on trust: projects return equipment when they believe they can get it back, and only reservations the warehouse honors make that belief reasonable.
Three changes make a practical starting point. Attach a project and a custodian to every checkout. Record return-date changes so that each one triggers a reservation check. Count equipment as available only when it is cleared for use. Then measure productive utilization against eligible hours, by equipment class, so the next decision to buy or rent rests on records the warehouse trusts.
To see how those steps work in EZO EAM, book a demo focused on project assignments, reservations, returns, and maintenance holds, or review the documented capabilities and current plans first.
